A failed check stops the job — in the factory and on the scaffold.

A quality system that files a note is a filing system. This one stops the next operation, and on site it stops the handover.

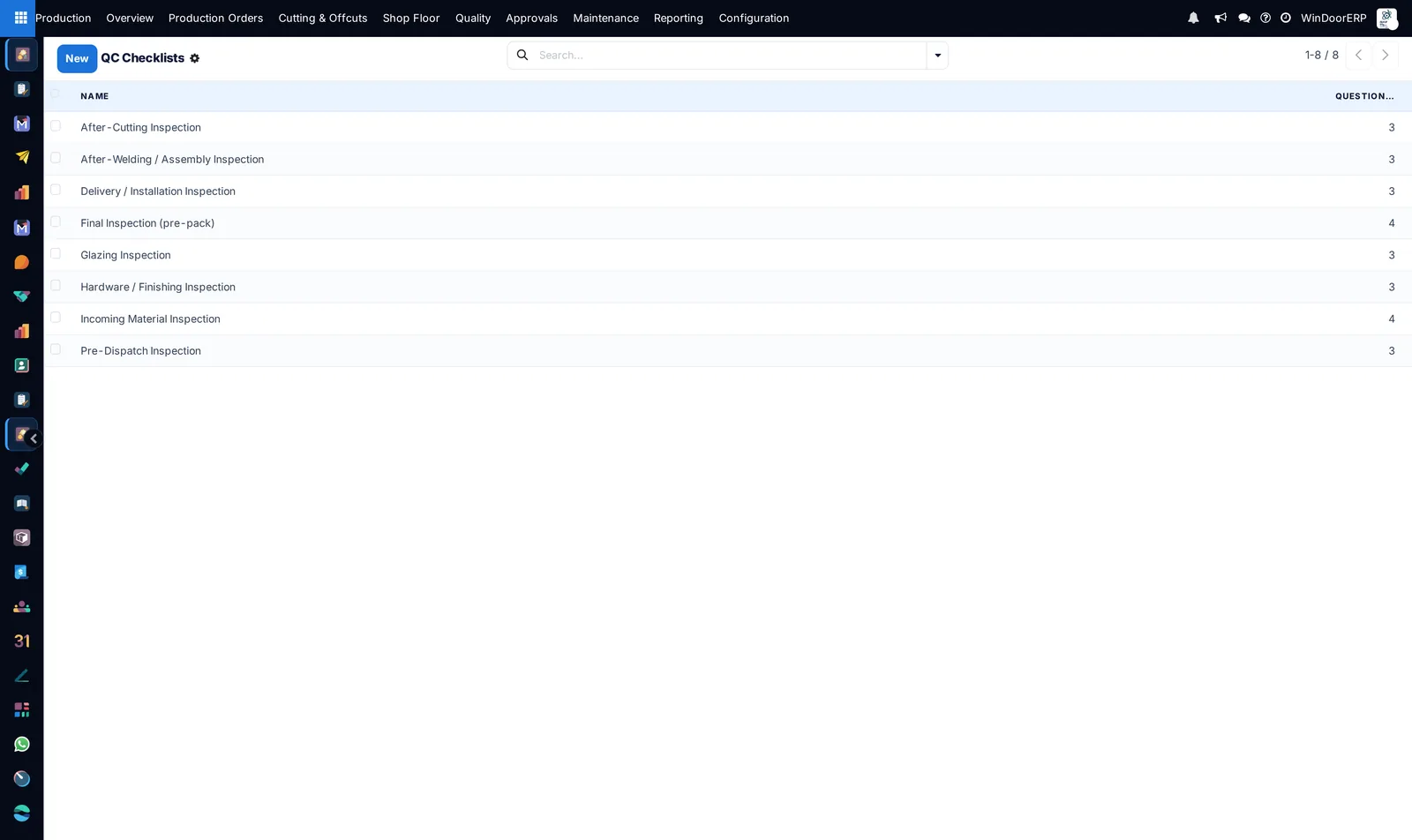

The quality checklist library, covering every inspection stage
01Eight inspection stages

Eight stages, from the gate to the site

  • Incoming material, after cutting, after welding, glazing, hardware, final, pre-dispatch and delivery
  • Yes/no, pass/fail, a measurement with tolerances, a pick list, or a required photo
  • Weighted scoring, with a reason code and a fail action per question
  • A checklist that was never loaded cannot be evaluated — the hole that would let empty answers pass a gate
The checklist library
The checklist library
02Blocking gates

The gate is a gate

  • A failed blocking check holds the item and raises a non-conformance
  • A held item’s operations refuse to become ready or to start
  • Pre-dispatch quality blocks loading; delivery quality blocks the transfer

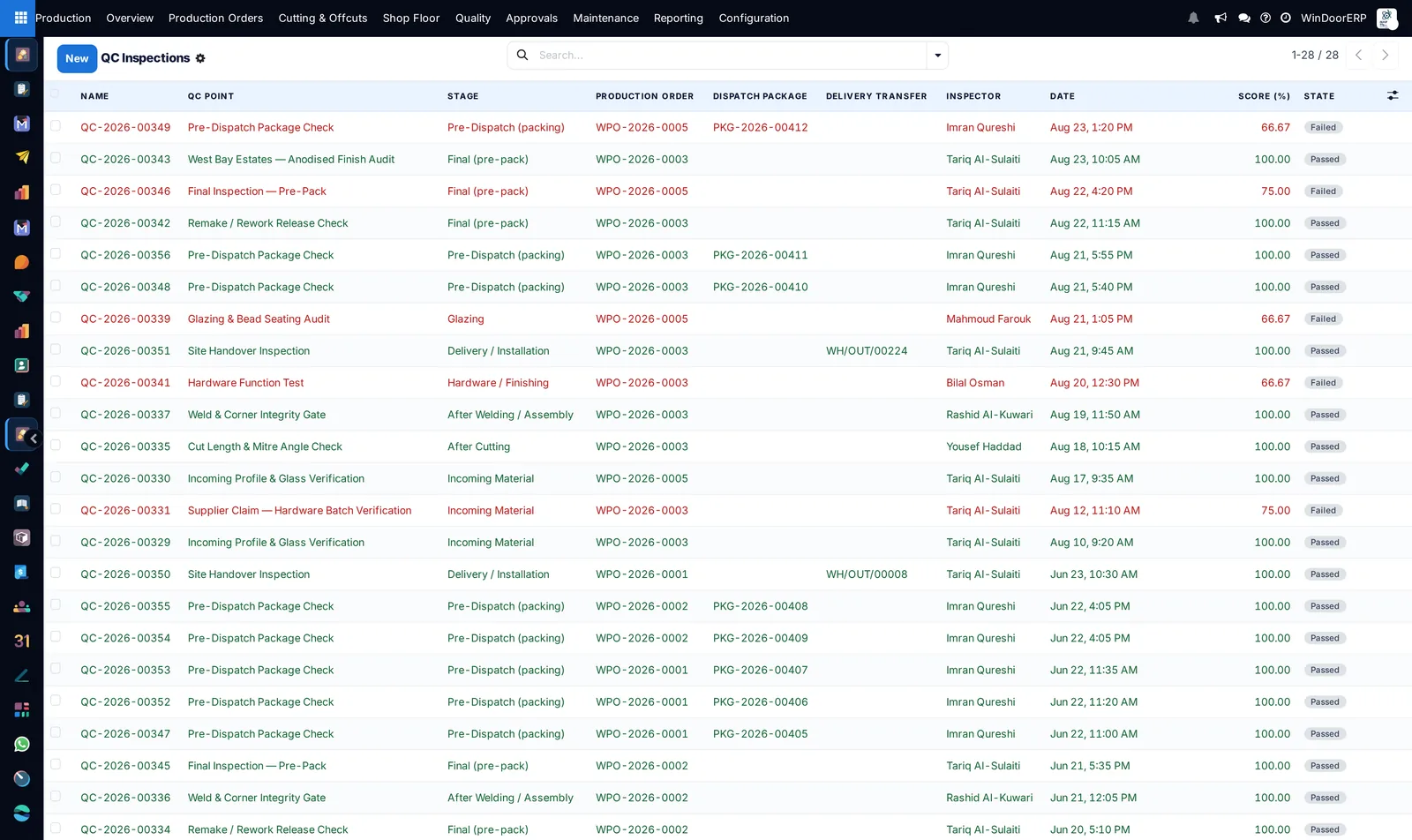

Quality inspections
Quality inspections
03Non-conformance dispositions

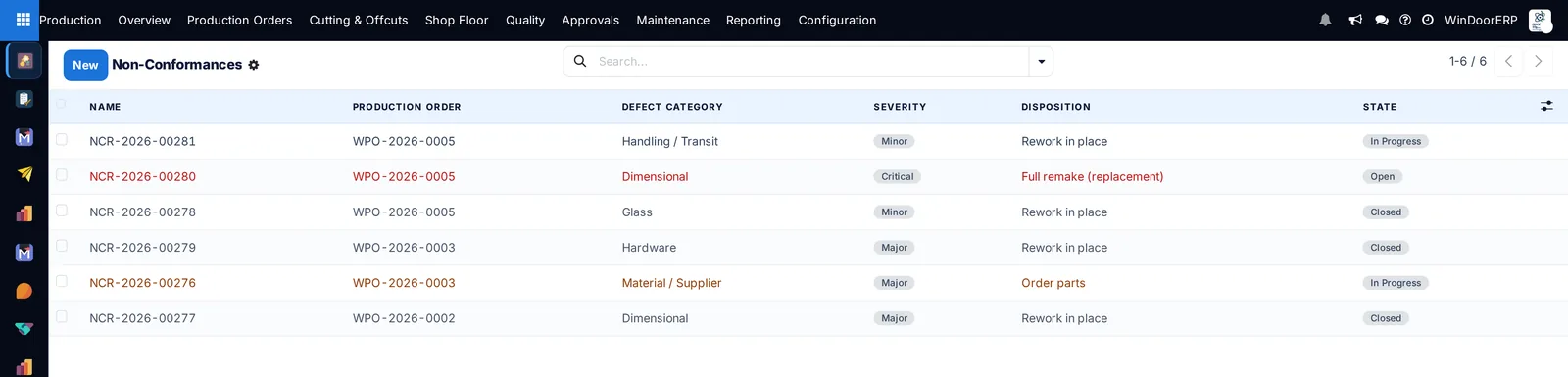

Non-conformances that name who may decide

  • Eight dispositions, each with an automated action and a minimum authority
  • Use-as-is stamps a signed concession
  • Hold-for-feedback carries a deadline, and a job re-escalates it
Non-conformances
Non-conformances
04Site inspections

On site, in the language the crew reads

  • Checklists written by the office without a developer
  • Question text and inspector guidance both translatable
  • Measurements with tolerance and the deviation recorded
  • A failure re-opens the earlier steps the crew must redo, and blocks handover until it is closed

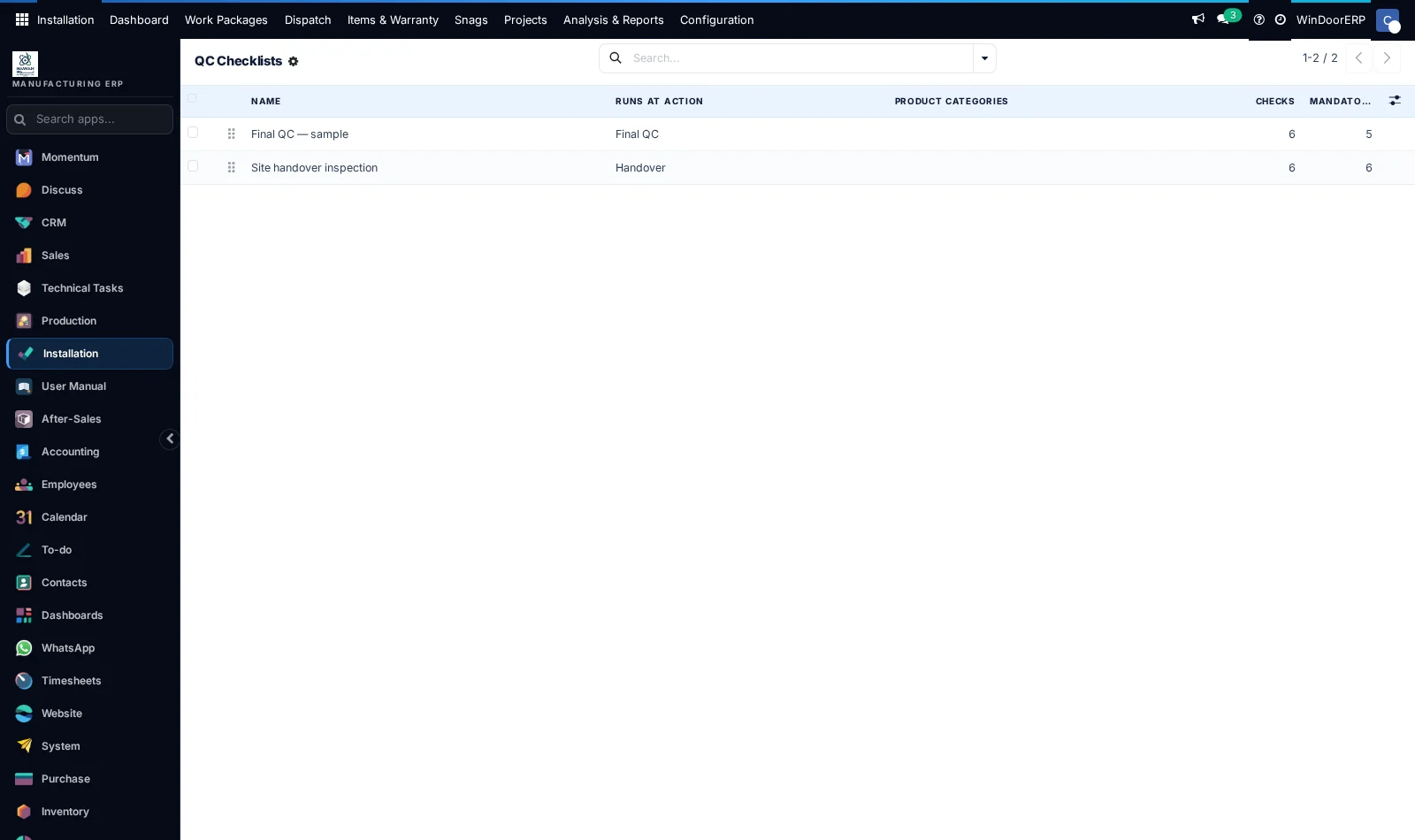

Site checklists
Site checklists

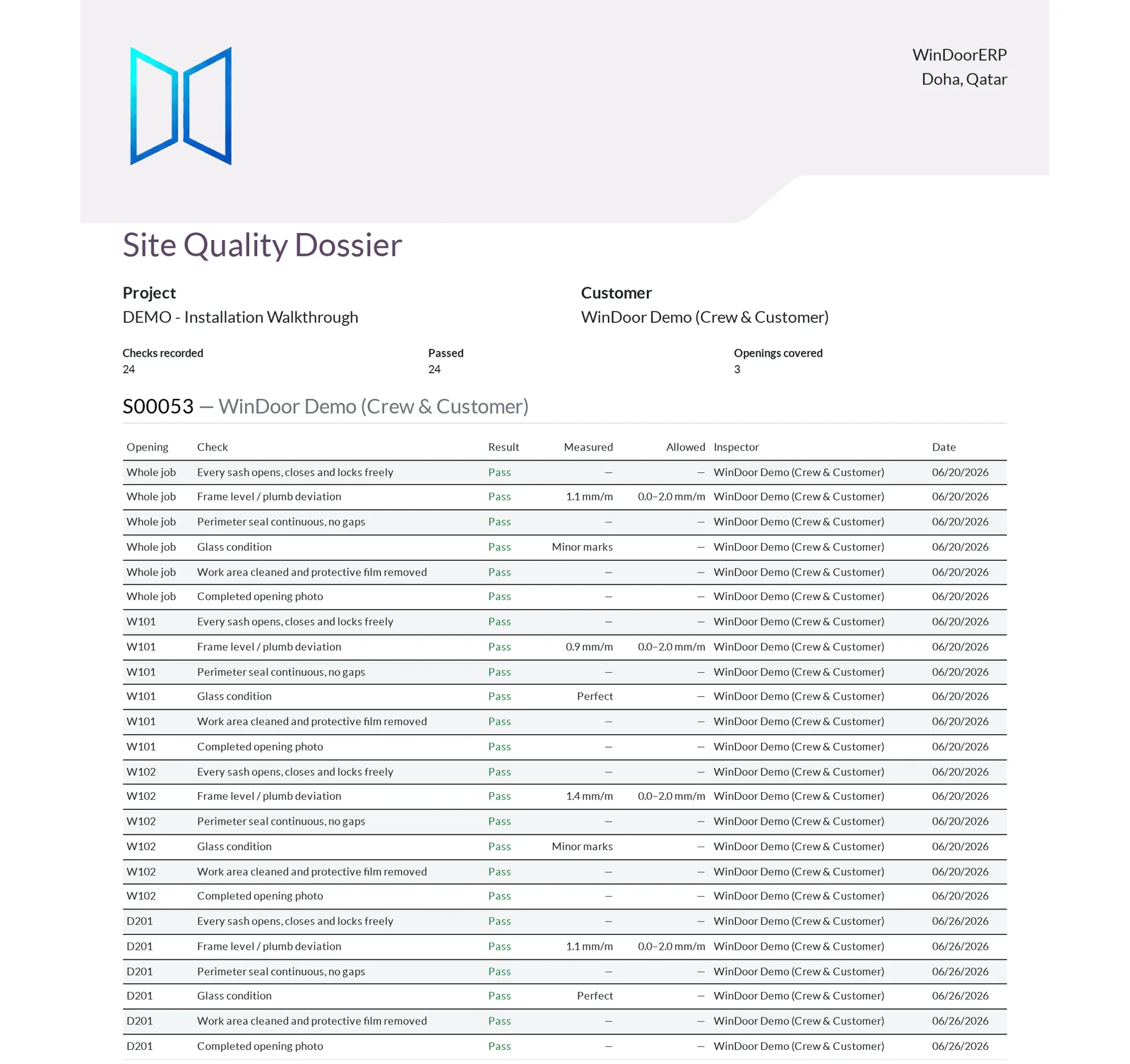

The site quality dossier, every check measured against its allowed tolerance
The site quality dossier, every check measured against its allowed tolerance
What this desk watches

The numbers on the wall

Quality and non-conformance analysis as a defect Pareto by root-cause stage and a severity-against-disposition pivot; site quality adds results, failures, first-pass rate, rework and measurements.

First-pass rate
Non-conformances by root-cause stage
Snags open against handovers due
What it produces
01A quality inspection record
02A non-conformance with its disposition
03A site quality dossier for handover
45 minutes, your job

Bring one opening. We will run it end to end.

A drawing, a profile system, or a quotation you have already sent. We load your catalogue into a live tenant and take it from the measured opening to a priced quotation, a costed material list, a nested cut list and a production record — with your hands on the mouse.

Book your demo Now!45–60 minutes · no slides · on a live database · English or Arabic · we reply within one business day
